Monthly Construction Report December 2025. Wyndham Grand Batumi Gonio. Riviera

Monthly Construction Report December 2025. Wyndham Grand Batumi Gonio. Riviera

Monthly Construction Report
December 2025. Wyndham Grand Batumi Gonio. Riviera

In December 2025, work continued on the main areas of the Wyndham Grand Batumi Gonio complex construction sites: monolithic construction, facades, engineering networks, and interior finishing. Work was carried out simultaneously on several sites, which allowed us to maintain a high pace and steady progress towards the key stages of the project.
Wyndham Grand Batumi Gonio. Riviera

Block A
— Work on the upper waterproofing of the balconies in the townhouses has been completed.
— Work on covering the chimney and drainage boxes with concrete has been completed.
— Facade work continues on the installation of XPS on terraces, reinforcement, and priming for decorative plaster.
— Work is being completed on the installation of electrical lighting and power supply in townhouses, as well as the installation of facade lighting.
— Switchboard equipment has been ordered and delivered to the townhouses.

Blocks B and C
— Work continues on the installation of upper waterproofing on the balconies in the townhouses.
— Work continues on the installation of electrical lighting and power supply in the townhouses.

Block E
— Work has been completed on covering the chimney boxes with concrete panels.
— Decorative facade elements have been ordered, delivered, and installation has begun.
— Facade work has been completed on the installation of mineral wool and reinforcement for mineral wool.
— Work is underway on the installation of decorative elements for the cornice.

Infrastructure building
— Facade work on mineral wool reinforcement is being carried out.

Landscaping

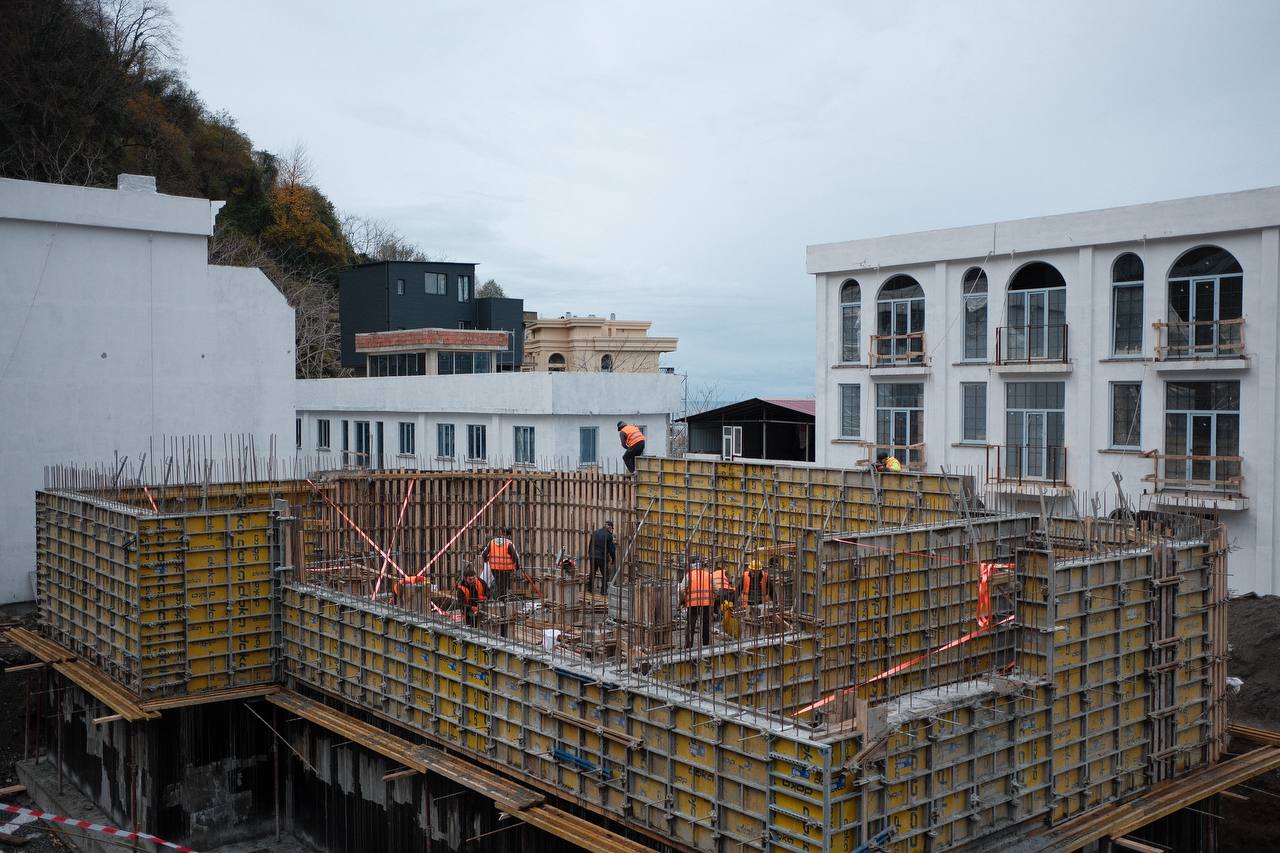

Monolithic work on the construction of the pool has been completed: installation of columns and pool slabs.
