Get a Consultation
Русский
Georgian
עברית

← All news

Monthly Construction Report

ProjectsPublished 1 min read
Share:Link copied
Monthly Construction Report

Monthly Construction Report
Wyndham Grand Batumi Gonio. Villas
October 2025

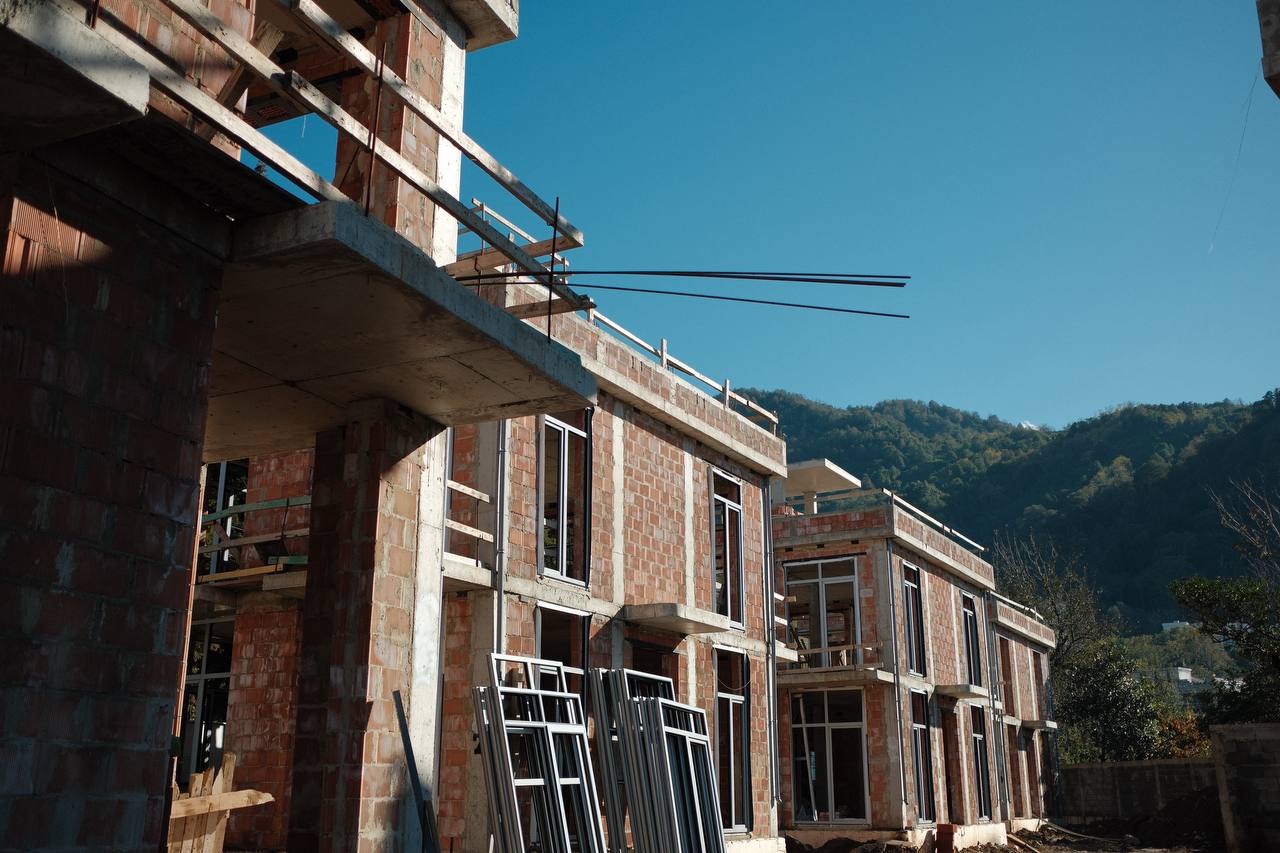

In October 2025, work continued on the main areas of the Wyndham Grand Batumi Gonio complex construction sites: monolithic construction, facades, engineering networks, and interior finishing. Work was carried out simultaneously on several sites, which allowed us to maintain a high pace and steady progress towards the key stages of the project.

— Monolithic work
Concrete work on the staircases of six villas has been completed.
— Masonry work
The masonry of the exterior walls of the second floor of all villas using ceramic blocks has been completed.
— Installation of fireplaces
Work has begun and is continuing on the masonry of fireplaces on the first floor of the villas and the masonry of chimneys.
— Stained glass glazing
Work is underway on the installation of frames for the subsequent installation of stained glass structures. Work continues on the installation of stained glass frames and double-glazed windows in villas 4–9 and 13.
— Facade work
Facade work is underway on the installation and reinforcement of mineral wool. Work has been completed on villas 2 and 3.
— Interior wall plastering
Work continues on plastering the interior walls of the villas. Completed on 3 villas. Plastering is underway inside villas 5 and 7.

Wyndham Grand Batumi Gonio Editorial

Author

Blog editorial team

We write about the Batumi and Georgia real estate market, hotel room investments and the construction progress of the complex.

All posts by the author →

More news
