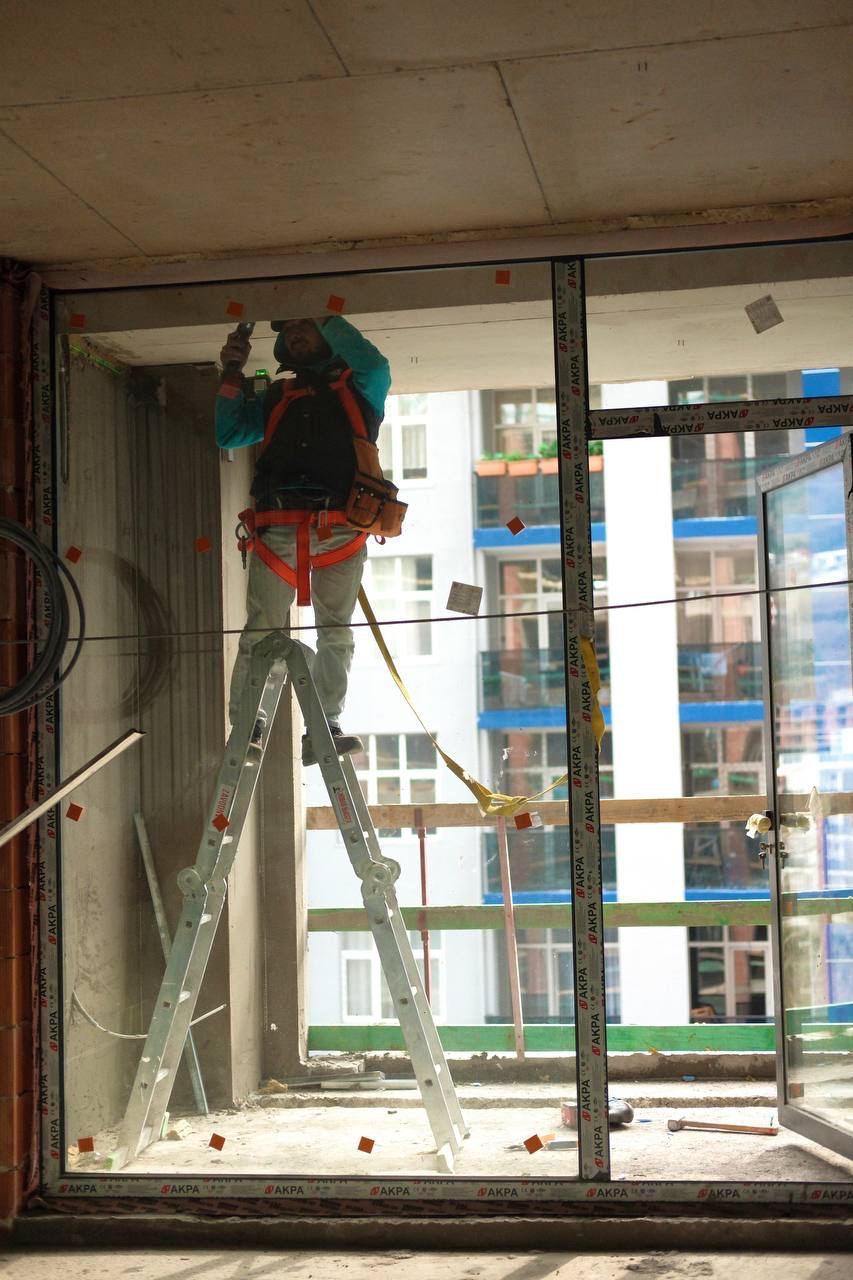

1. Facade works.
— Facade winterization, the 2nd, 3rd, 6th, 7th,11th, 20th floors.
— Facade plastering, the 14th — 20th floors.

2. Installation of utilities systems.
— Wiring, the 16th — 17th floors.
— Installation of water piping, the 20th floor.
— Connecting manifolds to water supply risers, the 3rd — 9th floors.
— Installation of exhaust ventilation, the 4th — 8th floors.

3. Fabrication and installation of steel arches
Balconies on the 20th floor.

4. Drywall frame installation.
On the 18th, 19th -20th floors.

5. Floor screeding.
On the balconies, the 19th floor.

6. Insulation.
Balconies, the 20th floor.

7. Mockup installation, the 13th floor.
Furniture assembly.

8. Installation of suspended ceilings.
Balconies, the 4th floor.

9. Diamond drilling of the engineering openings, the 8th — 11th floors.
Marking and drilling is carried out, which is necessary for the installation of engineering systems of the future hotel.

10. Elevator installation.
— Aerated blocks are being installed in the elevator shafts on the 10th, 20th floors.

12. Infrastructure building.
Ongoing pit excavation.
