Wyndham Grand Batumi Gonio. Aqua
1. Facade works.
— Facade winterization, the 3rd, 5th, 7th, 14th floors.
— Plastering of facade walls, the 2nd- 20th floors.
2. Installation of utilities systems.
— Hot and cold water supply risers are being installed (horizontal layout), the 8th, 15th — 16th floors.
— Wiring, the 18th, , 20th floor.
— Installation of the exhaust ventilation, the 15th -20th floors.
3. Fabrication and installation of steel arches
Balconies on the 20th floor.
4. Suspended ceiling installation.
On the balconies, the 3rd floor.
5. Waterproofing
Balconies of the 4th floor.

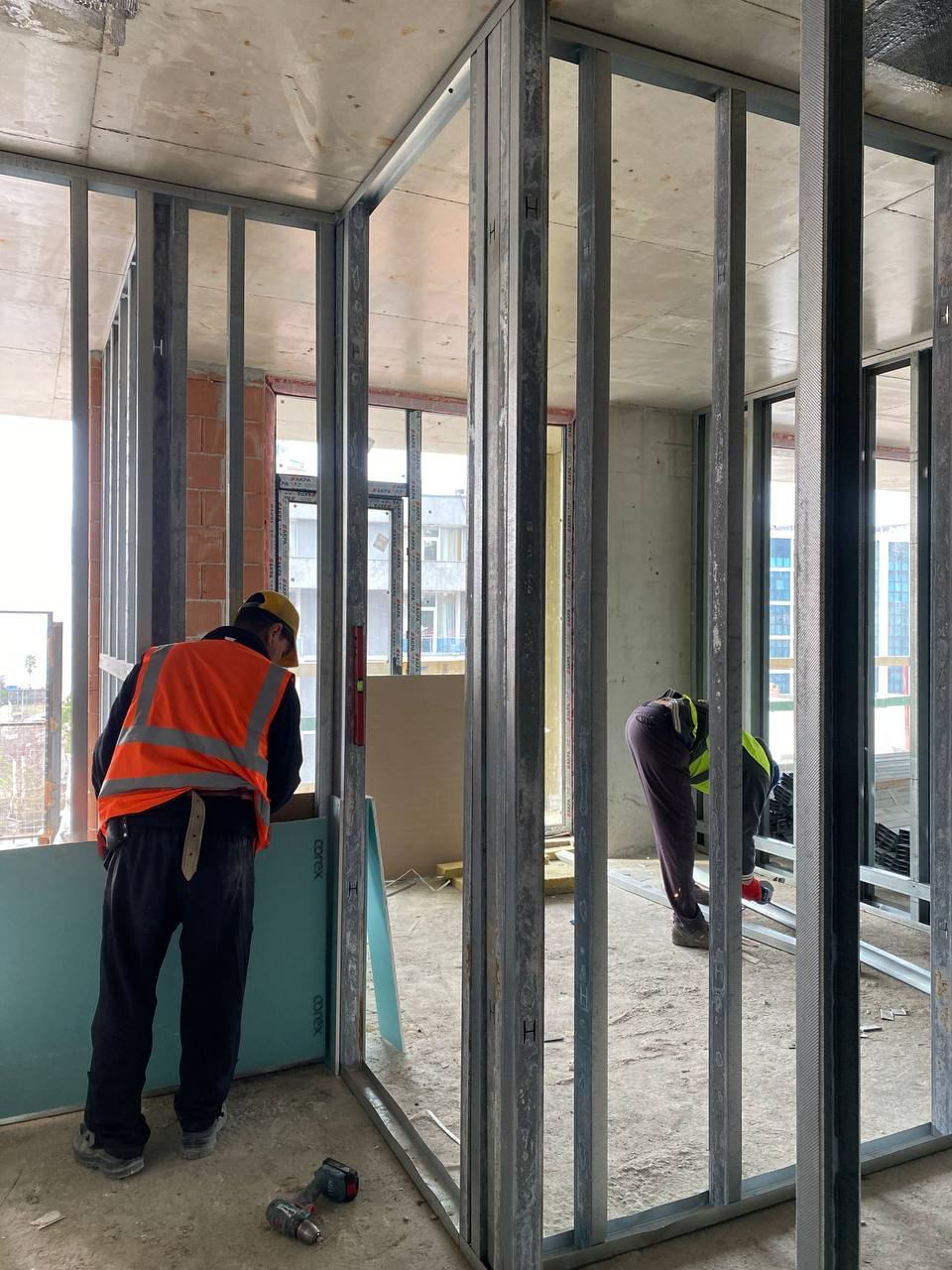

6. Drywall frame installation.
On the 3rd- 6th floors.
7. Floor screeding.
On the balconies, the 3rd — 19th floors.
8. Delivery of materials.
Elevator equipment was delivered.
9. Stained glass window installation.
On the 3rd — 20th floors.
10. Mockup construction on the 13th floors.
— Finishing works.
11. Diamond core drilling for engineering openings, the 3rd, 10th floors.
Marking and drilling of precise openings for the installation of utilities in the future hotel.
12. Infrastructure building.
Installation and connection of power supply on the site.
