Wyndham Grand Batumi Gonio. Aqua
1. Facade works.
— Facade winterization, the 4th, 5th, 11th floors.
— Plastering of facade walls, the 2nd- 20th floors.
— Installation of balcony railings, the 3rd floor.
2. Installation of utilities systems.
— Water supply system installation on the 6th -9th, 11th- 18th floors.
— Power supply, the 18th floor.
— Installation of the exhaust ventilation, the 3rd -5th floors.
3. Fabrication and installation of steel arches
Balconies on the 20th floor.
4. Suspended ceiling installation.
On the balconies, the 3rd floor.
5. Waterproofing
Balconies of the 9th floor.

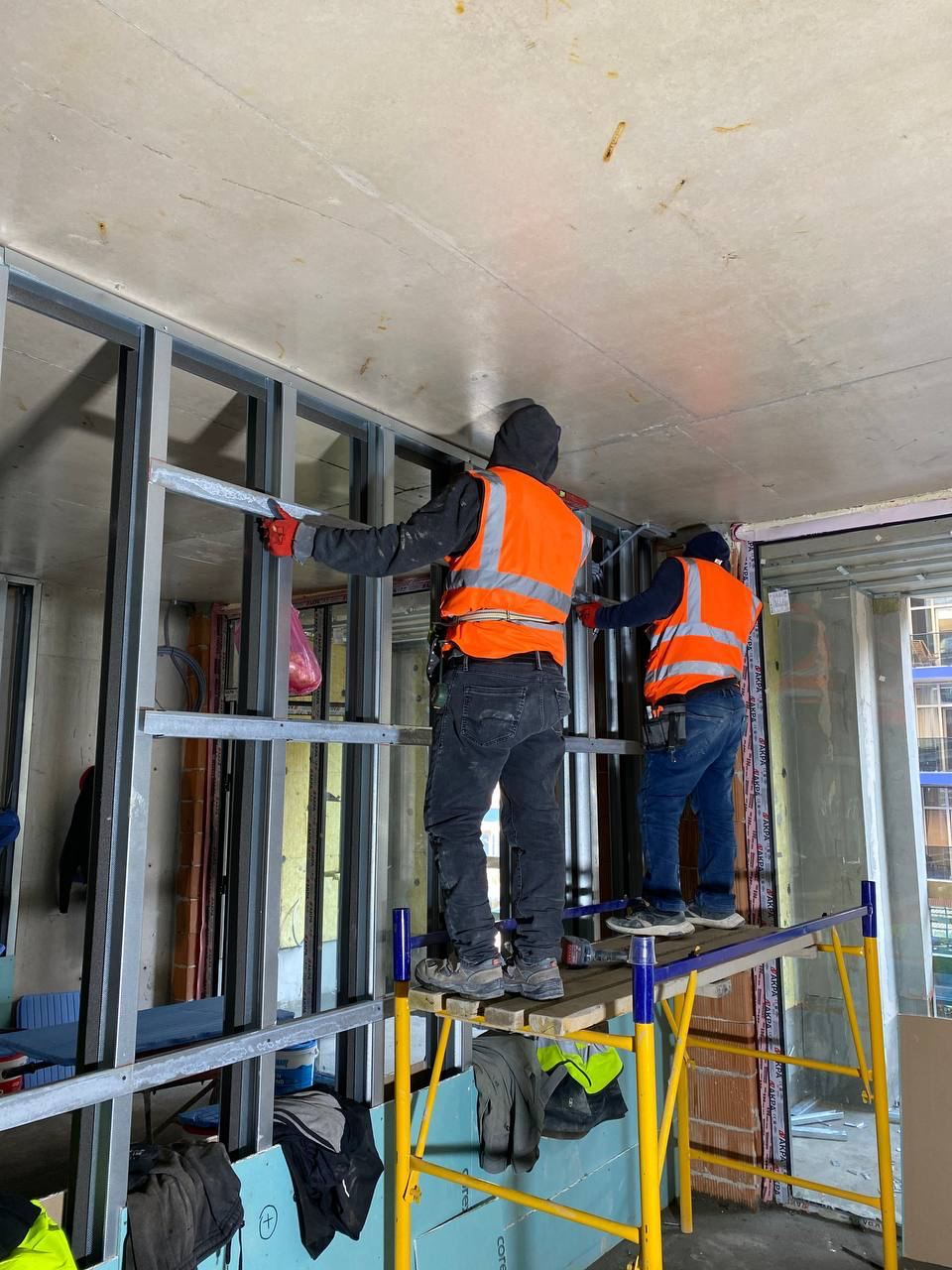

6. Drywall frame installation.
On the 5th — 6th, 18th — 19th floors.
7. Floor screeding.
On the balconies, the 3rd, 19th floors.
8. Installation of the elevator.
Installation of elevator shaft beams on the 17th — 20th floors.
9. Mockup construction on the 13th floors.
— Wallpapering.
— Installation of balcony railings on the central facade.
10. Diamond core drilling for engineering openings, the 10th -14th floors.
Marking and drilling of precise openings for the installation of utilities in the future hotel.
11. Infrastructure building.
Ongoing excavating.
