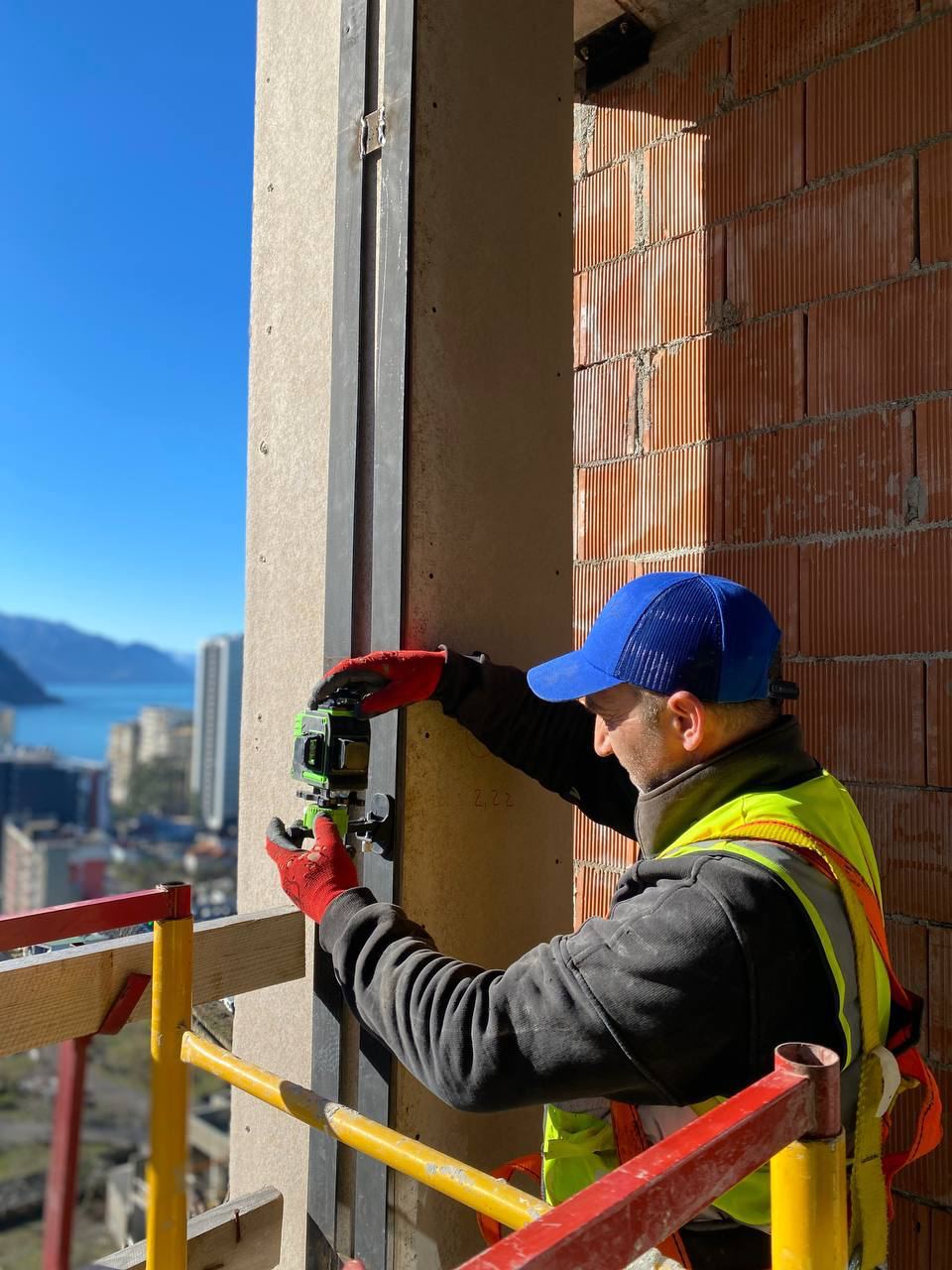

1. Facade works.
— Facade winterization, the 5th, 7th, 14th floors.
— Plastering of facade walls, the 2nd- 20th floors.

2. Installation of utilities systems.
— Hot and cold water supply risers are being installed (horizontal layout), the 5th, 12th, 14th, 18th floors.
— Wiring on the balconies, the 20th floor.
— Installation of the exhaust ventilation, the 11th floor.

3. Diamond core drilling for engineering openings, the 3rd, 4th floors.
Marking and drilling of precise openings for the installation of utilities in the future hotel.

4. Elevator shafts installation
Laying of gas silicate blocks, the 19th — 20th floors.

5. Fabrication and installation of steel arches
Balconies on the 9th, 19th floors.

6. Mockup construction on the 13th floors.
— Puttying of the ceiling.

7. Suspended ceiling installation.
On the balconies, the 3rd floor.

8. Waterproofing
Balconies of the 5th — 14th floors.

9. Drywall frame installation.
On the 20th floor.

10. Floor screeding
On the balconies, the 4th floor.
